Choose the project format
Compare Simple Project, WBS with Deliverable Scheduling and WBS with Resource Scheduling, and what each one means for planning, timesheets and deliverables.
After a new project is saved, Consult asks how hours will be planned on it. The answer sets the project format, which decides three things:
- Planning: What a project manager enters planned hours against.
- Timesheets: What employees capture their time against.
- Deliverables: Whether the project has deliverables, and whether time on each one can be capped.

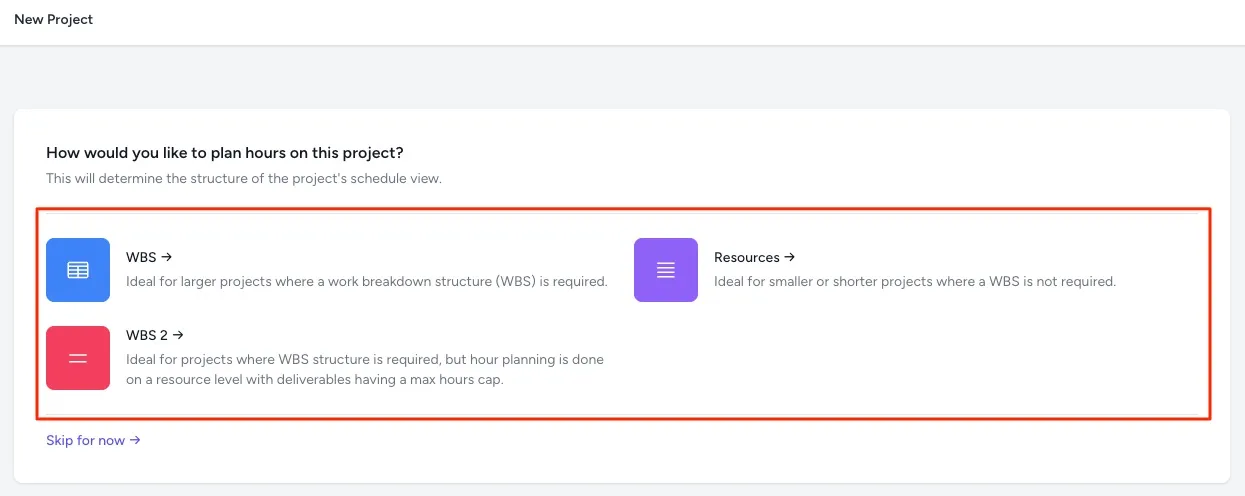

Warning: The format cannot be changed in Consult once it has been chosen. Decide on it before building the organogram and planning hours.
Selecting Skip for Now leaves the format unset. The schedule and organogram stay unavailable until a format is chosen.
Project formats compared
| Simple Project | WBS with Deliverable Scheduling | WBS with Resource Scheduling | |
|---|---|---|---|
| Planned hours are entered | Per resource, per week | Per resource, per deliverable, per week | Per resource, per week |
| Deliverables | None | Required | Required |
| Employees capture time against | The project | Each deliverable they are assigned to | Each deliverable they are assigned to |
| Cap on hours per deliverable | Not available | Not available | Optional maximum per resource on each deliverable |
| Schedule upkeep | Lowest | Highest | Low |
The format does not affect rate cards, the organogram or timesheet approval.

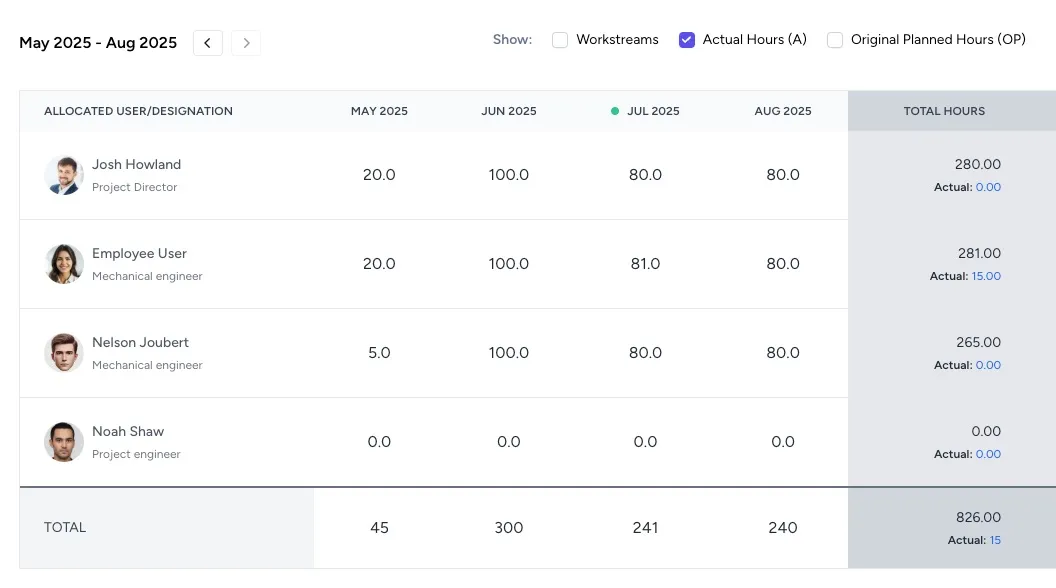

Simple Project
Hours are planned per resource, one row per person on the schedule. There are no deliverables, so employees capture all their time against the project as a whole.

In the timesheet, each Simple Project appears as a single row:

Choose a Simple Project when there is no need to know which part of the work the time went to. Typical examples are short engagements, retainers and internal work.
WBS with Deliverable Scheduling

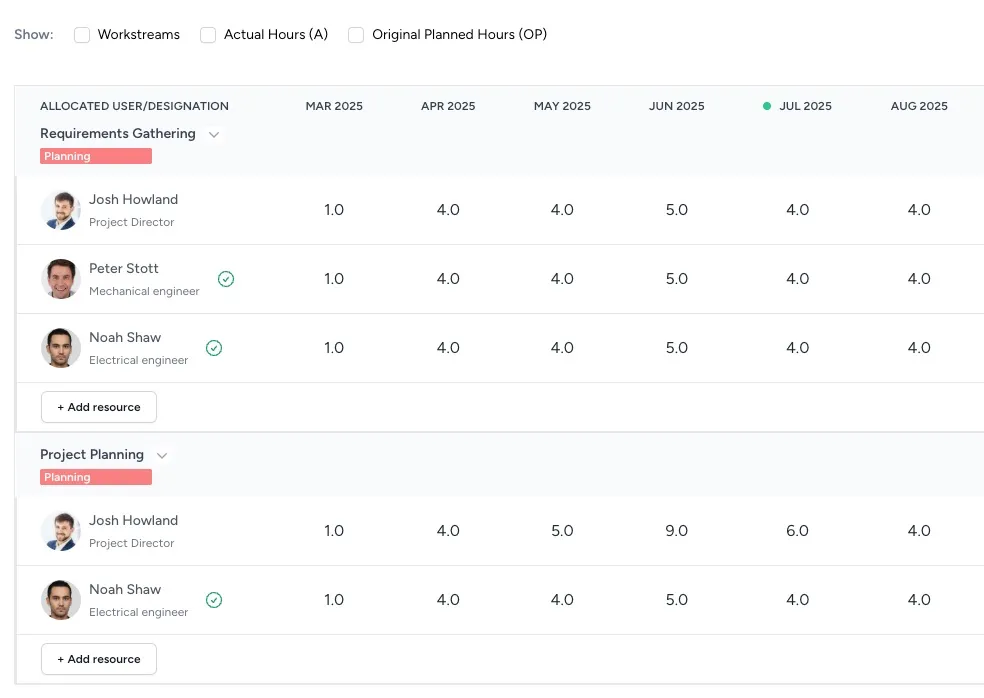

The work is broken down into deliverables, and hours are planned for each resource on each deliverable. The schedule shows one block per deliverable, with the resources assigned to it listed underneath. Every resource needs a forecast on every deliverable they work on, which makes this the most detailed format to maintain.

In the timesheet, the project row shows the week’s total and expands into one row per assigned deliverable. Employees capture time on the deliverable rows, and each row shows the forecast for that deliverable:

Note: A resource only appears in timesheets once they are assigned to at least one deliverable.
Choose WBS with Deliverable Scheduling when the forecast for each deliverable matters. See WBS with Deliverable Scheduling example employee training for a worked example.
WBS with Resource Scheduling

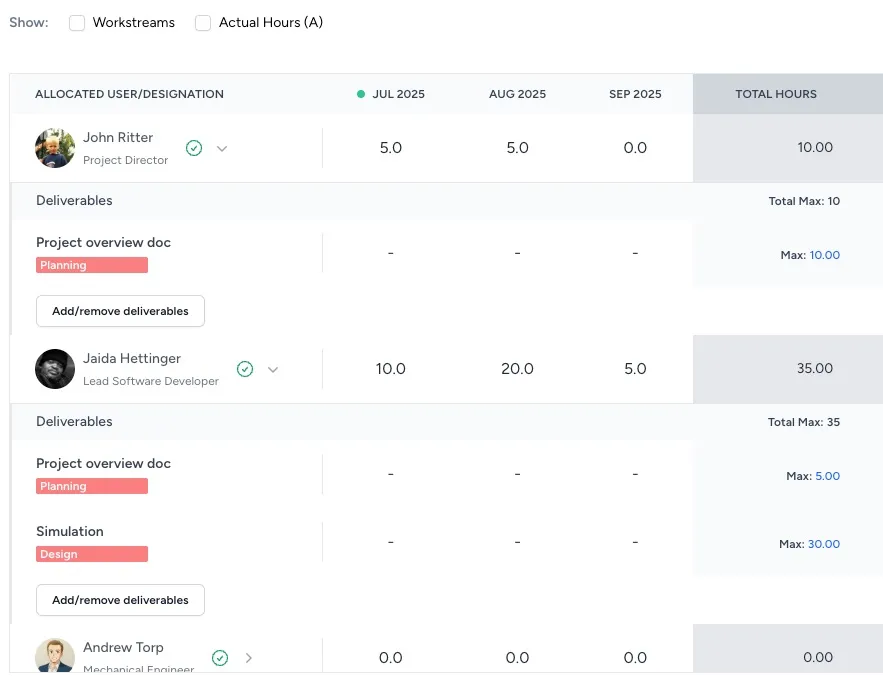

The work is broken down into deliverables, but hours are planned per resource, as on a Simple Project. Each resource then decides how to spend their forecasted time across the deliverables assigned to them. This gives the visibility of deliverables with far less schedule upkeep.
The schedule shows one block per resource, with the deliverables assigned to it. The deliverable rows are read-only and show each resource’s maximum on that deliverable, if one is set:

Note: Maximum hours per deliverable are optional, and add complexity. Add maximum hours only where overruns on a deliverable must be stopped. Where a maximum is set, Consult refuses further hours on the deliverable once the person reaches it, and shows a message naming the deliverable.
In the timesheet, employees capture time on the deliverable rows. Each row shows To Date, the hours captured so far, and Max, the cap for that person on that deliverable, if one is set:

Choose WBS with Resource Scheduling to see where time went by deliverable without forecasting each deliverable. See WBS with Resource Scheduling example project setup for a worked example.
